What you need to know now about second-story addition cost calculators:
- A second-story addition cost calculator gives you a starting range, usually $100,000 to $750,000 or more, but it cannot see your foundation, your roofline, or your county’s permit requirements.
- Northern Virginia projects tend to land on the higher end of national ranges because of local labor costs and Fairfax County’s structural review process.
- The two biggest gaps in most online calculators are structural engineering and soft costs like architect fees, permits, and temporary housing, which can add 25% to 40% on top of construction.
What a calculator gives you is a starting point for the conversation, not the final answer. Here’s what actually moves that number up or down, and what most calculators leave out entirely.
What Does a Second-Story Addition Cost Calculator Actually Show You?
A second-story addition cost calculator shows a national average cost range built from thousands of completed projects, not a quote for your specific house. Most tools output $100,000 to $250,000 for a typical project, with an average around $175,000, based on square footage and a generic finish level you select from a dropdown.
Want a calculator result built around your specific project instead of a generic dropdown menu? Our free pricing tool factors in your project type before you ever talk to a contractor. Try the calculator →
That average works fine for a first gut check. A contract needs something more specific.
The number changes based on three inputs most calculators ask for:
- Total square footage of the new floor
- Finish tier (builder-grade, mid-range, or high-end)
- Whether you’re adding a bathroom or kitchen upstairs
What it doesn’t ask about, and can’t factor in, is your home’s existing foundation condition, your roofline complexity, or whether your jurisdiction requires extra engineering review. That’s the gap between a calculator estimate and a real number.

How Much Does a Second-Story Addition Cost Per Square Foot?
A second-story addition costs $100 to $300 per square foot on average, with high-end finishes and complex structural work pushing that as high as $500 per square foot. On an 1,100-square-foot addition, that spread alone represents a difference of more than $400,000 between the low and high end.
Here’s how that breaks down by common addition sizes, based on national cost data:
| Square Footage Added | Typical Total Cost Range | Cost at $500/sq ft (High-End) |
|---|---|---|
| 400 (single suite) | $40,000–$120,000 | $200,000 |
| 600 (suite + office) | $60,000–$180,000 | $300,000 |
| 900 (two-bedroom wing) | $90,000–$270,000 | $450,000 |
| 1,100 (full floor) | $110,000–$330,000 | $550,000 |
The gap between the low end and the high-end column isn’t padding. It reflects the real difference between a builder-grade addition and one with custom millwork, upgraded HVAC zoning, and premium exterior materials matched to an existing brick or stone facade.
Northern Virginia homeowners should expect to sit toward the higher side of these ranges. Labor costs in the DMV region run above the national median, and homes in established neighborhoods like McLean, Vienna, and Great Falls often carry older electrical and plumbing systems that need upgrading as part of the project.
If you’re comparing a second-story addition against other ways to add space, our Second-Story Addition Ideas guide breaks down 15 specific layouts homeowners are building right now, from primary suites to home gyms.
How Much Does a Partial Second-Story Addition Cost Versus a Full Addition?
A partial second-story addition, covering one room or suite over part of your home’s footprint, typically costs $60,000 to $250,000. A full second-story addition, covering the entire first-floor footprint, runs $200,000 to $750,000 or more depending on square footage and finish level.
Partial additions cost less for a simple reason: less roof comes off, less foundation needs reinforcement, and the project disrupts a smaller portion of your existing home.
Most Northern Virginia homeowners we work with start by asking about a full addition and end up choosing partial once they see the cost difference against what they actually need. A primary suite above the garage solves the space problem without touching the rest of the roofline.
How Do Partial and Full Additions Compare in Practice?
Choosing between the two comes down to how much space you actually need versus how much disruption your household can handle. A partial addition solves one specific problem. A full addition rebuilds the entire upper floor at once.
- Partial addition: Lower cost, shorter timeline (3 to 6 months), less disruption to the ground floor
- Full addition: Higher cost, longer timeline (6 to 12 months), but more consistent finish quality across the whole upper floor
What Structural Engineering Costs Does a Calculator Usually Miss?

A calculator rarely itemizes structural engineering, but it’s one of the first real costs you’ll pay. A structural engineer’s evaluation runs around $550 on average, and any foundation reinforcement work identified in that evaluation starts at $5,000 and can climb into the tens of thousands depending on what your existing footings can support, according to HomeAdvisor.
Most single-story homes were never built to carry a second floor. The existing footings, load-bearing walls, and sometimes the entire foundation need evaluation before a design gets locked in.
In Fairfax County, this step isn’t optional. A second-story addition is its own distinct permit category, listed separately as “Second-Story Over Existing Structure” in the county’s building record system, and it goes through Building Plan Review, Zoning, and sometimes the Fire Marshal’s office before a permit is issued, per Fairfax County’s Land Development Services.
Structural review changes what’s actually possible on your lot. Our team runs that evaluation before design work starts, not after. See how we plan additions →

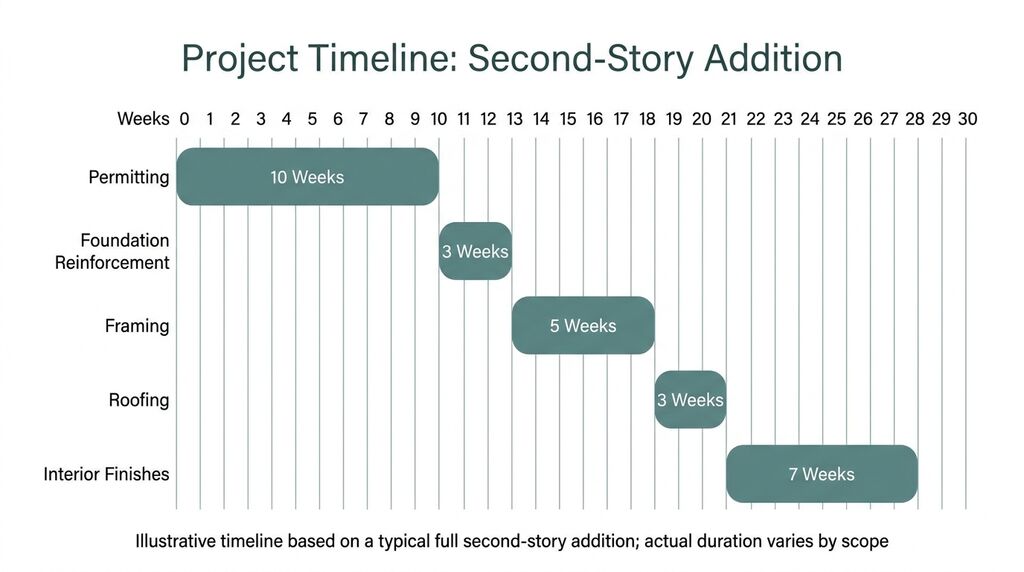

Why Do Roof and Demolition Costs Push the Number Higher?
Roof and demolition work adds significantly to a second-story addition because building up almost always means removing some or all of the existing roof first. Roof replacement alone runs $4.35 to $11 per square foot, and chimney removal, if your addition requires it, adds another $4,500 on average.
Two other line items catch homeowners off guard:
- Staircase installation or relocation: $2,400 to $4,000, higher for custom designs
- Room and interior demolition: Roughly $1,250 per room affected below the new addition
A full addition means the entire roof comes off before framing starts on the new floor. A partial addition only requires opening the roof over the section being built, which is one of the biggest reasons partial additions cost less overall.
What Soft Costs Does an Online Calculator Leave Out?
Soft costs, meaning architect fees, permits, and project management, typically add 25% to 40% on top of the raw construction number a calculator shows you. These costs cover the professional oversight and paperwork required to build legally and safely, and they rarely show up in a quick online estimate.
Here’s what’s usually missing from that first number:
| Included in a Typical Calculator Estimate | Usually Excluded |
|---|---|
| Base construction cost per square foot | Architect fee (8%–20% of project cost) |
| Generic mid-range finishes | Structural engineer evaluation (~$550) |
| Standard framing and roofing | Building permit fee ($1,200–$2,000) |
| x | Foundation reinforcement (from $5,000) |
| x | Post-construction cleaning ($300–$700) |
| x | Temporary housing during construction |
Materials alone can account for close to two-thirds of your total budget, with labor making up most of the remainder. A calculator’s per-square-foot figure usually assumes standard materials and a straightforward build. Anything custom, from matched brick to a complex roofline, moves that percentage.
How Much Does Fairfax County Permitting Add to Your Timeline and Budget?
Fairfax County building permits for a second-story addition run $1,200 to $2,000, and the review process typically adds several weeks to your timeline before construction can begin. Homes on a slab, homes with undersized footings, or homes in a floodplain or Resource Protection Area may face additional review steps.
The permit itself isn’t the expensive part. The delay is. Every week spent waiting on plan review is a week added to your temporary housing budget if you’re not staying in the home during construction.
Working with a contractor who has an established relationship with Fairfax County’s Land Development Services and knows the common plan review comments in advance shortens that timeline meaningfully compared to a first-time filer navigating the PLUS portal alone.
Curious how second-story costs stack up against other addition types in this market? Our Home Addition Cost guide for Northern Virginia covers ground-level additions and bump-outs alongside full second stories.
Does Adding a Bathroom Upstairs Change Your Calculator Estimate?
Yes, adding a bathroom to your second-story addition raises the per-square-foot cost significantly compared to a bedroom or office. Plumbing rough-ins, venting, and waterproofing require trades and materials a simple bedroom never touches. Where you place that bathroom relative to your existing plumbing matters just as much as the size of the room itself.
A bedroom addition runs $80 to $160 per square foot. A bathroom addition, because of the plumbing rough-in, tile work, and ventilation requirements, runs $150 to $200 per square foot or higher.
Two decisions matter most here:
- Stacking the new bathroom above an existing bathroom or kitchen cuts plumbing costs significantly, since the vent stack and supply lines are already nearby.
- Adding a bathroom in a new location away from existing plumbing requires new vent stack tie-ins, which a structural engineer needs to confirm before finalizing the layout.
What Should You Budget for Temporary Housing During Construction?

Most homeowners need temporary housing for two to twelve months during a second-story addition, since crews cut into the roof and main structure for an extended period. Partial additions run toward the shorter end of that range, while full additions with extensive roof and foundation work run longer.
Options range widely in cost:
- Staying with family or friends nearby: little to no added cost
- An extended-stay hotel: variable, but often the most expensive option over several months
- A short-term rental: typically the middle ground for cost and convenience
Budget for this line item before you finalize your construction contract, not after demolition starts. It’s the cost calculators skip most consistently, and it’s rarely small.
What Return on Investment Does a Second-Story Addition Actually Deliver?
A second-story addition can return up to 65% of its cost at resale, a higher recovery rate than most other addition types, according to Angi’s cost research. Building up preserves yard space that a ground-level expansion would eat into. It also typically requires less new foundation work than adding on at grade, which keeps more of your budget going toward finished living space instead of site prep.
Resale value isn’t the only return worth measuring, though. Residential remodeling activity is projected to grow 3% in 2026, and the National Association of Home Builders points to the country’s aging housing stock and record home equity as the two forces driving that growth, according to NAHB.
Households holding a mortgage rate locked in below today’s market are choosing to expand in place rather than sell and buy at a higher rate. That equity access, combined with genuinely needing more space, is why demand for additions like this has held steady even as the broader housing market has cooled.
What Should You Look for in a Second-Story Addition Partner?

The right partner treats the structural engineering evaluation as the first step, not a formality to check off after the design is already drawn. Everything else about your project, from cost to timeline, depends on what your existing framing can actually support.
“We’ve walked away from second-story projects after the structural review because the existing foundation simply couldn’t support it affordably,” says Gene Gamble, President of Renewal Homes and a civil engineer by training. “That’s a conversation worth having before you fall in love with a design, not after.”
A few things worth asking any contractor before you sign:
- Do they run a structural engineering review before finalizing the design, or after?
- Is the estimate fixed-scope, or does it leave room for surprise change orders mid-build?
- Have they pulled permits through Fairfax County’s Land Development Services before, and do they know the common plan review comments?
Want to know how we approach that first structural conversation? Learn more about our engineering-led process. Meet our team →
What Should You Do Next With Your Calculator Number?
Treat your calculator result as a starting range, not a budget. The next real step is a structural conversation, not a contract.
A short discovery call and a home visit will tell you whether your specific foundation, roofline, and lot realistically support the second-story addition you’re picturing. From there, expect a design phase with layouts and renderings before any construction estimate gets finalized.
There’s no cost and no obligation for that first conversation, and it’s the only way to turn a national average into a number you can actually plan around.
Frequently Asked Questions about Second-Story Addition Cost Calculators
Are online second-story addition cost calculators accurate for Northern Virginia homes?
They’re accurate as a starting range, but they use national averages that don’t reflect Northern Virginia’s labor costs or Fairfax County’s permit requirements. Expect your real number to land toward the higher end of whatever range a calculator gives you, especially once structural engineering and permit review are factored in. Treat the calculator output as step one, not the final budget.
Can I get a second-story addition cost estimate without a home visit?
You can get a rough range without one, but not a reliable number. Foundation condition, roofline complexity, and existing electrical and plumbing layouts all affect cost significantly, and none of that is visible from a photo or a square footage input alone. A home visit and structural review are what turn a range into an actual estimate.
Does a cost calculator account for HOA or historic district review?
No, and this is one of the most commonly missed costs in the Northern Virginia market. Homes in HOA communities or historic districts often face additional design review before a county permit is even submitted, which can add weeks to the timeline and sometimes requires specific exterior materials that cost more than standard options.
How much does a structural engineer’s report typically add on top of a calculator estimate?
A structural engineer’s evaluation runs around $550 on its own, but the real cost impact comes from what that evaluation finds. If your foundation needs reinforcement, that work starts at $5,000 and can run significantly higher depending on your home’s age and existing footing depth.
Should I get multiple calculator estimates before contacting a contractor?
One calculator estimate is enough to set expectations. Running several tools rarely changes the range meaningfully, since most pull from similar national cost databases. Your time is better spent scheduling a structural evaluation with a contractor, since that’s the step that actually narrows a wide national range into a number specific to your home.
Your Second-Story Addition Cost Starts With a Real Number
A calculator gets you in the right ballpark. It doesn’t account for your foundation, your county’s permit process, or the specific finishes that make an addition feel like it belongs on your house instead of bolted onto it.
Renewal Homes has walked Northern Virginia homeowners through that gap between a national estimate and a real, buildable number for years, with a civil engineer reviewing structural feasibility before design work ever starts. If your calculator result left you with more questions than answers, that’s normal. It’s supposed to be a starting point.
Ready to turn your calculator estimate into a real number for your home? Talk to our team about your project. Schedule your free consultation →
